WHY RENOVATION WORK ON THE CHAPEL ?
The Chapel of Notre-Dame du Haut by Le Corbusier, inaugurated on the 25th June 1955, has not undergone the appropriate repair of the concrete used in the middle of the last century, which has been damaged over time.
All buildings need permanent maintenance according to the evolution of their materials over time.
Various kinds of deterioration include :
Surface scaling : the surface mortar flakes off as a result of the corrosion of steel reinforcing.
Structural cracks are due to chemical reactions inside the materials used in the concrete mix or poor construction practices.
The Southern façade was made by projecting concrete on an iron framework. This technique was quite new at the time. It requires a deep
understanding of how the concrete will react over time to the thermal stresses caused by extreme seasonal temperature variations.
Watertight integrity needs to be monitored at all times. The contact between different materials causes joints to be fragile.
The window panes are also fragile elements. The various glass types, the cold or hot technique used for the writings and drawings account for this fragility. They are also vulnerable to vandalism or accidents.
The building was repainted regularly until 1995.
As a consequence, the roughcast has been overloaded with paint and needs to be cleansed before receiving the matt white coating originally provided by whitewash.


The buildings
The renovation work will deal with the three main buildings of the site: the Chapel of Notre-Dame du Haut, the Pilgrim’s Shelter and the Chaplain’s House.
The Chapel was listed as Historical Monument only twelve years after it was built, on the 8th November 1967. The two adjacent buildings were listed as Historical Monuments on the 11th June 2004.
A first study made in July 2011 enabled to assess the cost of the renovation of the three buildings.
In January 2015, a series of studies examined the different techniques to cleanse the facing and to open the cracks, they identified the
repair materials and studied how to protect the window panes. They made it possible to find renovation methods.
The intervention program is divided into 5 parts: 1 firm part and several optional parts
The firm part
Until September 2022

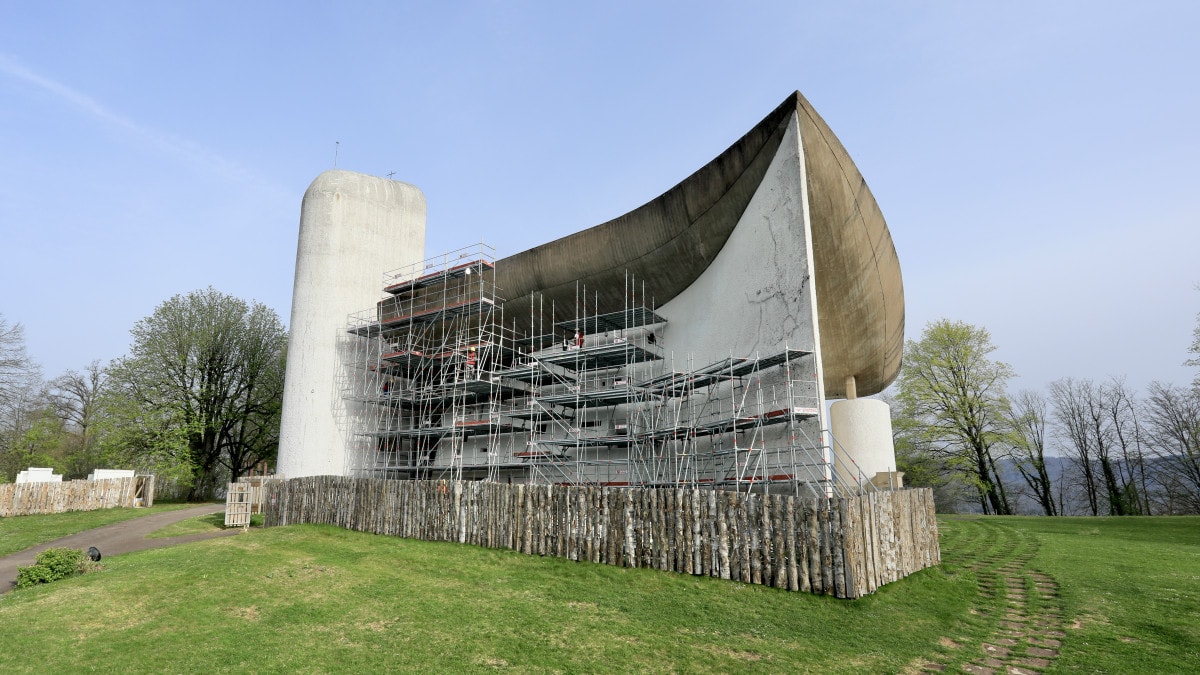

The firm part concerns essentially the restoration of the south façade and the underside of the hull. This restoration will begin with a topographic survey of the building’s volume and the and the very precise identification of the cracks. The results of the experimental interventions carried out since 2015 will make it possible to validate and refine the intervention protocol if necessary.
Then, the cracks and oxidized metal lattices will be treated. The waterproofing will be restored and reinforced. The cladding will also be treated and repainted to make it look as close to the original state as possible.
It should be noted that this phase will be the occasion to carry out conservation measures on the Pilgrim’s Shelter and the Chaplain’s House pending their subsequent restoration.
Optional part 1
From September 2022 to November 2022
Restoration of the west façade.
Optional part 2
From October 2022 to December and March 2023
Restoration of the north façade of the chapel.
Optional part 3
From March 2023 to August 2023
Restoration of the east façade of the chapel.
From August 2023 to December 2023
Restoration of the south-west tower of the chapel.
Optional part 4
From January 2024 to July 2024
Restoration of the chapel’s interior.
Optional part 5
From July 2024
Restoration of the Pilgrim’s Shelter and the Chaplain’s House.
VISITING THE SITE DURING THE RENOVATION PROJECT ?
Visitors will be allowed on the Hill of Notre-Dame du Haut during the whole period of renovation work,
To respect the work of all the people who are renovating the Chapel, it is important to pay attention to the safety measures recommended by the Porterie staff when buying your entrance ticket.
he visitor will discover the Pilgrim’s Shelter, the Chapel by Le Corbusier, the campanile by Jean Prouvé, the oratory of St Clare monastery by Renzo Piano. Guided tours, digital tours or guiding maps translated into 9 languages will be offered, thanks to different devices.
The opening times of the site are liable to change as safety regulations may evolve.
To be informed in real time of the opening times, please consult the website of the Hill by clicking on “informations pratiques” (useful information).





Contact Mécénat
ASSOCIATION ŒUVRE NOTRE-DAME DU HAUT
Jean MEMBRE
13 rue de la chapelle 70250 RONCHAMP
06 08 67 53 83
03 84 20 65 13
FUNDING OF THE RENOVATION WORK
Given the significant cultural heritage of the buildings, the management committee with all its members, local, regional and State ServicesServices directed by the Préfet of Haute-Saône, has been working since 2017 to identify the renovation schedule and the funding.
Along with the State, the local and regional authorities conserve this cultural heritage.
All the partners are fully aware of the importance of this unique architectural site and give their unreserved support to the conservation works.
As an exceptional measure public funding will meet 90% of the total cost of the repair work :
50% will be funded by the DRAC
20% each from the Burgundy Franche-Comté Region and the Département of Haute-Saône.
The association which owns the Chapel is to fund the remaining 10% cost.
The total cost of the renovation works will reach 2.3 million euros.
As a result, the cost paid by the association will be 230,000 euros.
The main sponsors
CGPA
CGPA Group provides Professional Indemnity
Insurance. Committed to preserving and showcasing cultural heritage, CGPA has wished to support the Association de l’Oeuvre Notre-Dame du Haut to renovate the Southern façade by funding €30,000 in 2017.
Crédit Agricole
The Crédit Agricole of Franche-Comté and the Crédit Agricole-Pays de France Foundation are committed to local and regional development by rolling out initiatives favoring local heritage as well as economic and social welfare
everywhere in France. As an exceptional measure, in 2020 they supported the site for €50,000 in funding, of which €25,000 are attributed to the renovation project.
Other sponsors
For other investments and projects necessary to keep the Hill of Notre-Dame du Haut alive, firms and private individuals have been supporting the Association de l’Oeuvre de Notre-Dame du Haut for many years.
Among the firms, Vétoquinol, Lisi, Grande Distillerie Peureux, Cristel, Centre Leclerc de Lure, Pépinières Guillaume, Hommes & Méthodes, Velleminfroy, Medi Service are to be noted.
Becoming a donor or a sponsor ?
Funding this ambitious project goes beyond the usual needs of the site. Such donations are necessary to make the repair programme possible.
To ensure it can fund 10% of the renovation costs, the association which owns the Chapel has set up a fundraising partnership, with help from the Fondation du Patrimoine.
The Fondation du Patrimoine has been supporting the Association de l’Oeuvre Notre-Dame du Haut since 2016 by organizing fundraising campaigns soliciting firms and private individuals. After funding the preliminary studies, it aims now at funding the works themselves.
A subscription has been started for the firm part:
On the Internet
www.fondation-patrimoine.org/43707
By cheque to Fondation du Patrimoine-chapelle de Ronchamp
Fondation du Patrimoine
14 rue Violet 25000 Besançon
It is also possible to send your donation directly to the AONDH
By cheque to AONDH :
AONDH
13 rue de la chapelle 70250 Ronchamp
By bank transfer
IBAN FR76 1250 6700 5256 5265 3811 673
AGRIFRPP 825
Donation receipts will be sent.




Websérie
2021 - 2024, la chapelle en chantier
Episode 1 : le béton, c’est quoi ?
Episode 2 : la façade Sud, comment est-elle construite ?
Episode 3 : pourquoi la chapelle a t’elle besoin d’être restaurée??
Episode 4 : les différentes phases du chantier
Episode 7 : les fissures de la façade Sud
Episode 5 : les pathologies des bétons
Episode 8 : les enjeux du protocole
Episode 6 : les restaurations de la Façade Sud
Episode 9 : les enjeux du protocole
